Lötschberg Base Tunnel, Second Tube: Automated Cost Optimization of the Inner Lining

To realize the integrated synchronized timetables in long-distance traffic and to increase the capacity in freight traffic between Brig and Bern, the two-lane extension of the Lötschberg Base Tunnel (LBT) is necessary. This demands the installation of an inner lining over 14 km in the second LBT tube. Considering the excavation profile available, a skillful choice in the sequence of formwork carriage geometries (FCGs) can lead to optimization of the concrete volume to be installed, the feasibility of the build and the construction sequences. In the sense of a “proof of concept”, mathematical optimization algorithms are used to find a cost-optimal sequence of FCGs for a defined tunnel section. The article in tunnel 5/2021 describes the chosen approach and the results of the cost optimization.

1 Project Overview

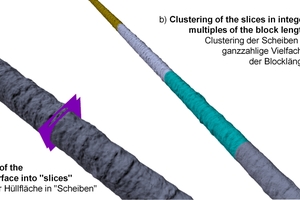

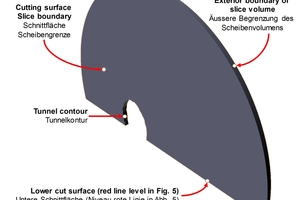

The Lötschberg Baseline – comprising the 34.6 km long Lötschberg Base Tunnel (LBT) and the 2.6 km long Engstlige tunnel in the north – has been in operation since 2007. Due to limited financial resources during construction, the Lötschberg Baseline could not be completed over its entire length with two separate single-track tubes.

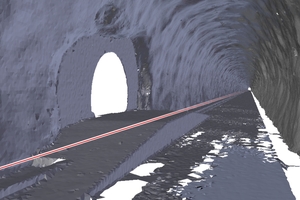

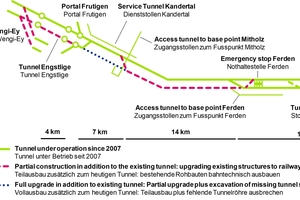

Currently, only the east tubes are in continuous operation (Fig. 1). The west tube of the LBT has been upgraded in the south over almost 14 km between the Raron south portal and the Ferden emergency stop. However, from the Ferden switch point to the...

Related articles:

Issue 06/2009 Formwork Technology

Stable Tunnel Formwork Carriage with flexible Design

A large number of infrastructural schemes are being executed in the region for the 2014 Winter Olympics to be held in the Black Sea resort of Sochi. These include a roughly 13??km long bypass for the...

more

Custom Timber Formwork for the Feuerbach Tunnel

However, the three companies Baresel Tunnelbau GmbH, Kunz Untertagebau GmbH and Bertschinger Bau GmbH, organised in a consortium, completed the Feuerbach Tunnel in spring 2022. All customised...

more
Issue 04/2019

Potentials for Optimisation of In-Situ Concrete Tunnel Construction

On these criteria – optimisation of both productivity and process costs – formwork specialist Peri unveiled at the 2019 bauma construction-machinery fair in Munich (Germany) a number of remarkable...

more
Issue 06/2011 Gotthard Base Tunnel

Fully-hydraulic Forming for complex Tunnel Cross-Section

In the Gotthard Base Tunnel’s Erstfeld section a fully hydraulic and flexibly adjustable tunnel forming carriage served to execute the inner shell for 2 branching structures, which tapered greatly in...

more
Issue 01/2023 Formwork Technology

Fully Hydraulic Crawler Driven Formwork Carriage for Varying Tunnel Cross-Sections

Since May 2020, tunnel construction work has been underway to the north and south of the Danube for the future accesses and exits of the suspension bridge. Five different tunnel cross-sections, the...

more
